An open-source, dependency-driven scheduling and project controls engine for Microsoft Excel.
Download the latest release · English documentation · Documentation française · Report an issue
Drag a task. See the schedule propagate, the critical path change, and the calculated plan return with Reset.
Most Excel Gantt templates are static timelines.
They can display dates and colored bars, but they do not understand the logic connecting activities. When one task slips, successors must be checked manually. Critical activities can change without warning. Floats, deadlines, progress curves and reporting can quietly become inconsistent.
ProjectEngine turns the workbook into a real scheduling system.
Define the WBS, dates, progress, calendars, constraints and dependencies. ProjectEngine calculates the network, propagates changes, identifies the Critical and Longest Paths, measures float, surfaces planning risks and keeps the Gantt, analytics, Dashboard and S-Curve aligned.
All inside the Excel environment your organization already uses.
| Static Excel Gantt | ProjectEngine |
|---|---|
| Successor dates are reviewed manually | Dependency logic propagates the change |
| Critical activities may be missed | Critical and Longest Paths are recalculated |
| Float is absent or maintained separately | Total and Free Float are recalculated |
| Conflicts can remain hidden | Structured INFO, WARNING and STOP diagnostics identify them |
| Reporting can drift away from the schedule | Gantt, analytics, Dashboard and S-Curve consume the same calculated planning data |
| Alternatives require duplicated workbooks | TEST and SCENARIO workflows evaluate changes before they are applied |
Most Excel Gantt templates draw schedules. ProjectEngine calculates them.
ProjectEngine is designed for people who need a dependable planning model, not a decorative timeline:
- planning engineers and schedulers;
- project controls and PMO teams;
- project managers working primarily in Excel;
- engineering, EPC, construction and infrastructure projects;
- shipbuilding, manufacturing and industrial programmes;
- teams familiar with Microsoft Project or Primavera P6 but working without access to those licenses;
- organizations where Excel is available everywhere but additional software is not.
ProjectEngine can also distinguish criticality across multiple projects in the same workbook, supporting programme-level analysis rather than treating every activity as part of one undifferentiated schedule.
ProjectEngine does not claim to replace every capability of Microsoft Project, Primavera P6 or a full enterprise project management suite.
It fills a different gap:
Professional dependency-driven scheduling for teams that need to remain in Excel.
Activities, summaries, milestones, Level of Effort tasks, constraints, dependencies, progress and critical-path overlays remain connected to the same scheduling model.
Review Critical and Longest Paths, Total and Free Float, Driving Logic, deadline exposure, schedule variance and multi-project criticality from a dedicated analysis layer.
Compare Baseline, Actual, Forecast and Calculated progress while viewing the time-phased workload behind the curves.
|
|
|
|
View the complete feature set
- Baseline, Actual, Forecast and Calculated planning;
- single-source dependency-driven calculation;
- signature-based incremental recalculation;
- forced full recalculation when required;
- full and partial output synchronization;
- protected calculated-column lifecycle;
- canonical task identity and parsed-network contracts.
- dedicated constraints table;
- hard-constraint calculation;
- deadline management;
- constraint-impact analysis;
- grouped dependency, constraint, cascade and upstream diagnostics;
- bilingual planning messages;
- stable event signatures;
- acknowledgement workflow.
- tasks, summaries, milestones and Level of Effort rendering;
- dependency links;
- progress, critical-path and longest-path overlays;
- constraints, deadlines and Today Line;
- fractional positioning in Week and Month scales;
- predictive Shape Registry;
- deterministic fallback and lazy geometry repair;
- independently refreshable Gantt, Dashboard and S-Curve outputs.
- Planning Reset for project turnover;
- Full Reset for complete workbook cleanup;
- Safe Empty State for Gantt and S-Curve;
- guarded WBS write scopes;
- owner-controlled output writers;
- transactional simulation workflows;
- isolated validation on temporary workbook copies;
- deterministic regression harnesses;
- no competing calculation engines across planning, simulation or reporting.
- Go to the latest release.
- Download the
ProjectEngine_*.xlsmworkbook from Assets. - Open it in Microsoft Excel and enable the workbook's macros.
- Use the integrated Quick Start guide on the WBS sheet.
- Enter activities, hierarchy, dates, progress and dependencies.
- Run Planning Update to calculate and publish the schedule.
- Review diagnostics, then explore the Gantt, analytics, Dashboard and S-Curve.
The WBS onboarding is available in English and French and includes:
- Required / Optional / Calculated field indicators;
- contextual help for every input column;
- an integrated Quick Start guide;
- automatic localization when the workbook language changes.
Download the prepared
.xlsmasset from the release page.
The automatically generated “Source code” archives do not contain a ready-to-use Excel workbook.

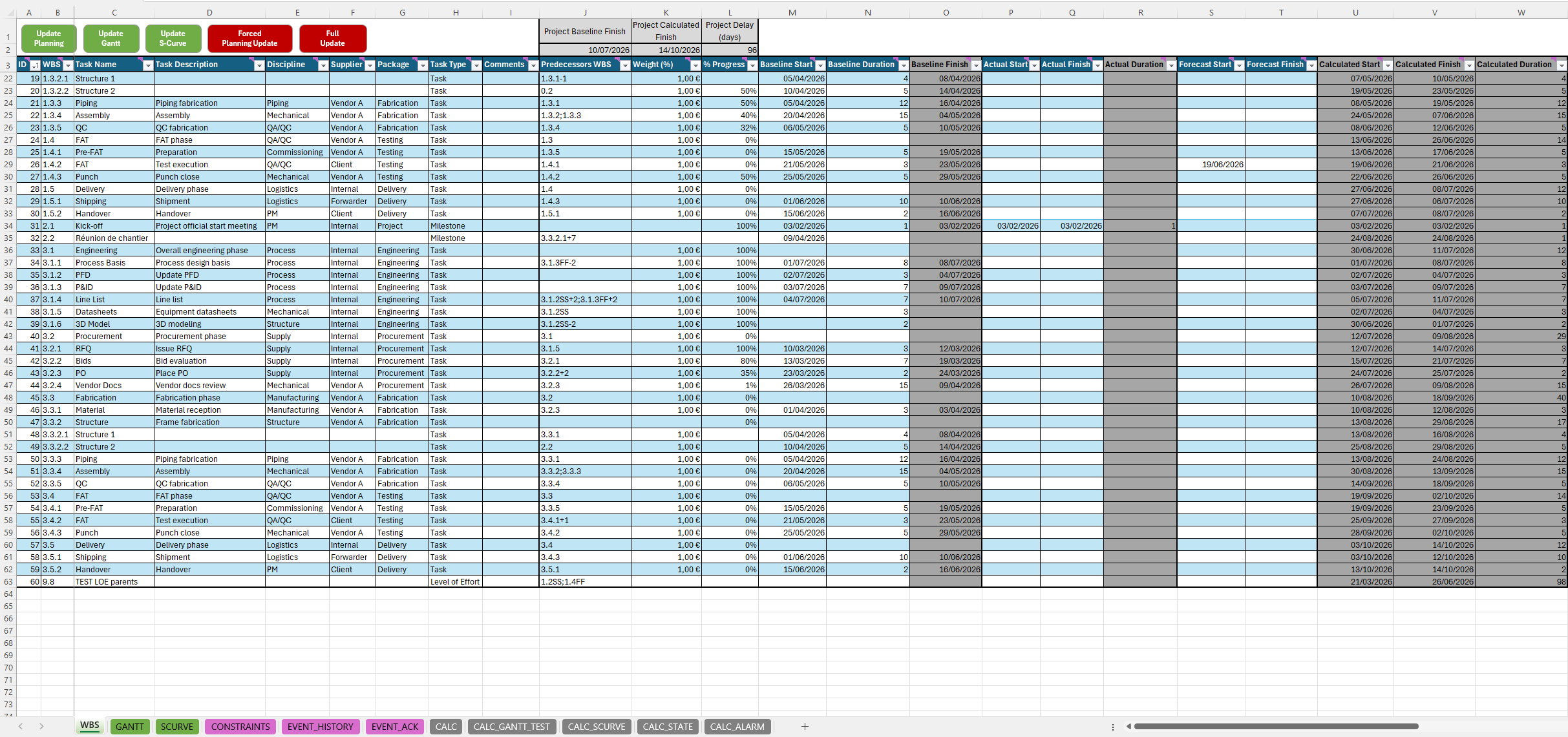

WBS inputs
↓
Planning Update
↓
Dependency network + calendars + constraints
↓
Calculated dates + rollups + schedule analytics
↓
Diagnostics
↓

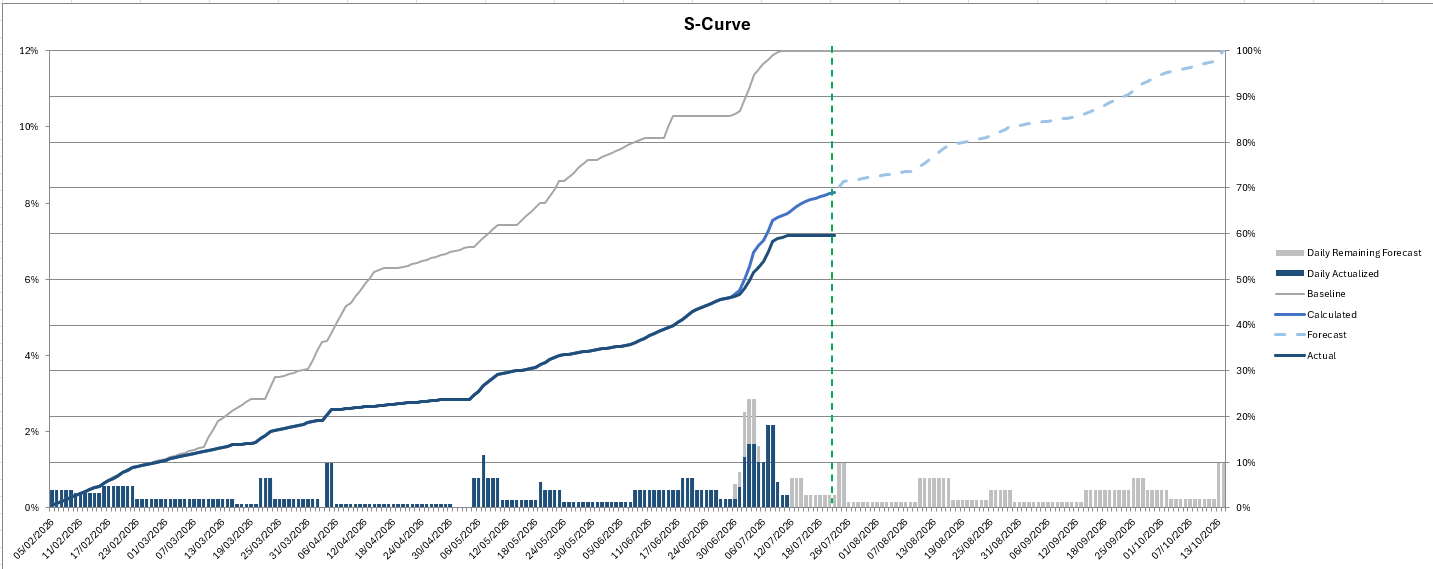

Gantt · Dashboard · S-Curve · Planning Analytics
↓
TEST / SCENARIO simulation
↓
Review and LOCK validated changes
- Build the WBS and define task types, calendars, dates, progress and dependencies.
- Add hard constraints or deadlines when required.
- Run Planning Update.
- Resolve any blocking
STOPdiagnostics and reviewWARNINGorINFOmessages. - Analyze Critical and Longest Paths, float, Driving Logic, deadlines and project health.
- Evaluate focused changes in TEST mode or create a complete SCENARIO.
- Review predictive differences before applying validated results with LOCK.
- Refresh the reporting view needed for the next planning or management review.
ProjectEngine is not a collection of disconnected worksheet macros.
The scheduling engine is the single source of truth. Simulation, diagnostics, visualization and reporting reuse its outputs rather than implementing their own competing date logic.
